Overview

IBM defines technical debt as “the future costs associated with relying on shortcuts or suboptimal decisions.” It’s usually applied to software development, but the term still applies to this small office. Mullen Family Dentistry is my parents’ local business in Northern California. While they’re great at working on teeth, they need my help on the technological side. I believe this accurately represents the approach a lot of small businesses take when it comes to tech: preserve what’s already there and just get things working. The problem with this methodology is that it becomes very hard to diagnose problems, and even more difficult to untangle when it’s finally time to do it right.

This was the situation I encountered in September 2026: layers of cables and devices, with no overall plan for how the infrastructure should be organized. I could clearly see each “generation” of adding on new equipment to what was there without removing or reworking what existed before. It was very obvious that they were due for an overhaul.

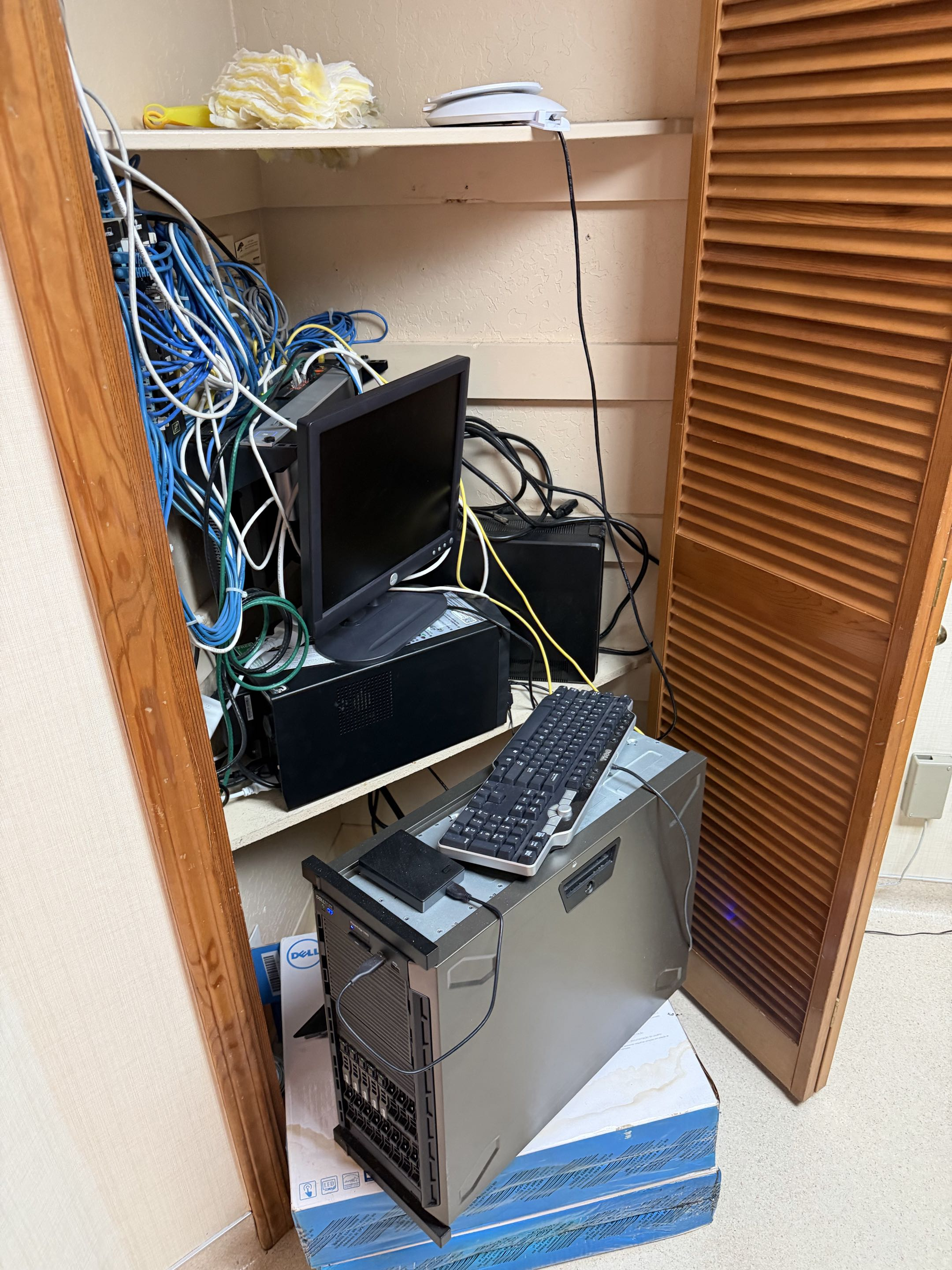

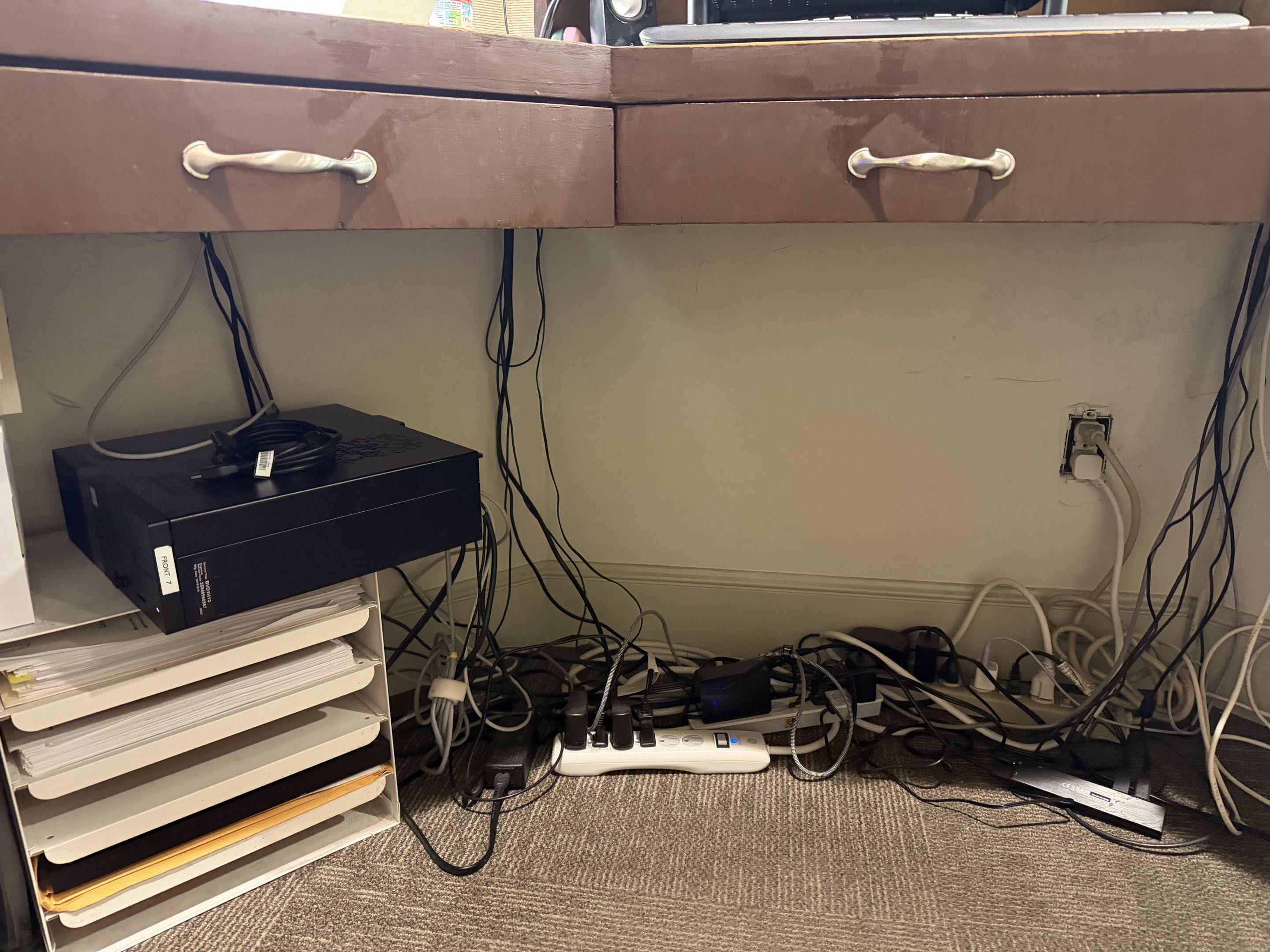

MFD servers, beforeMFD workstation, before

Mullen Family Dentistry’s Old Infrastructure and The Plan

During the discovery phase of the project, I carefully looked through all of the infrastructure that was in place so I could have a comprehensive view of what was there and what I could do to improve it. The office has four workstations and five rooms to support, along with other general locations like the back entrance and break rooms.

The server infrastructure was set up in a closet in the main office downstairs. Everything was placed on boxes and shelves, with a wall mounted rack system for the firewall, switch, and access point manager. As shown by the picture above, the order of what plugs into what was extremely difficult to discern. This setup also posed some security risks: since all of the equipment was out in the open the only way to secure it would be by locking the whole office. Placing everything in a server cabinet would be much more secure as its panels can be individually locked.

The most important part of this process was figuring out the existing patch panel layout. I used a cable tester and mapper to determine the location of each of the runs; while a majority of the runs were documented, some runs were unlabeled or unpatched and ended up not requiring support. After this was done, I could determine the new mapping order and create my table.

Before starting any work, I summarized my findings in a writeup that allowed me to give an overview of the project scope, my reasoning behind the choices I made, and keep track of what the expenses would be. It’s not necessary to read for the rest of this article as it’s meant for the customer, but it is included below.

Plan writeup

PDF preview is not available.Open the PDF.

Executing the Plan

The main implementation phase of the project happened over a weekend, since the work I was doing required the servers and internet to be down the office needed to be empty. As extending the structured cabling and moving the equipment over to the server rack would be a lot of work, I made sure to complete the tasks that didn’t require the equipment to be shut down first; including assembling the server rack and terminating the CAT6 extensions with their keystone jacks. On the first day of the shutdown, I coordinated with their managed service provider, Obsidian IT, to turn the equipment off so I could begin my work.

Building the Server Rack

The server rack came flat packed in multiple boxes; I assembled it first to give me a place to put the equipment after taking it out of the server closet. Re-locating the wall mounted equipment to the rack was the most straightforward, as those devices already used the 19” spec that is standard for server rack equipment. I placed these devices at the top, the switch went in between the patch panels while the firewall and access point manager went below. I’ve followed the best practices as far as rack layout goes: heaviest devices at the bottom, while lighter devices go at the top.

Re-locating the Dell T440 server was a little more involved since it’s designed to be a standalone tower instead of being mounted in a server rack. Fortunately, the T440 already came with the rack-mount upgrade equipment installed, all I needed to do was purchase the rails that it attached to and the server could become fully rack-mounted. This step was very important to the project as it allows the server to be pulled out from the rack like a drawer; since the server is large and weighs more than 60lbs it provides much easier access for service instead of having to lift the whole unit.

New server rack, frontNew server rack, backNew server rack, side

Extending the Structured Cabling

Once the equipment was out of the way, I could begin to extend the structured cabling. Since one of the goals of this project was to increase security around the equipment, it was important to have proper junction blocks where the drops can be terminated in and sealed. This is a better option over plugging into coupling adapters as it’s more secure, more organized, and the connections are direct.

This part of the process took the longest time as each drop required accurately matching each of the 8 strands from the inbound and outbound cables to each other. It was important to have a specific process for how the cables should go in and out of the junction blocks as the space was tight. For each row, inbound cables enter from the top while outbound cables exit through the bottom.

After making each connection, it was imperative that I used the cable tester to ensure each of the runs were still valid; testing one at a time was the best option here as it was very difficult to undo the connections after they were punched down. I ran into two kinds of failures when I was working on this part. Misalignments at the junction block: in a couple of cases I was going too fast and mismatched strands from the inbound and outbound cables, the fix was to simply take out the connector and re-align them. Errors at the keystone jack: two of the keystone jacks weren’t punched down properly according to the T568B standard, I could easily take out the keystones and fix the strands.

After ensuring all of the drops were extended and each of the runs passed cable testing I could turn on all of the equipment and restore operation to the infrastructure.

Structured cabling junction boxStructured cabling junction box installed

Applying Upgrades

With the infrastructure streamlined and modernized, it was quick and easy to swap out some of their hardware for upgraded versions. After coordinating with Obsidian IT, I scheduled another shutdown of the equipment so I can make my changes. The main upgrade being the switch, I swapped out their old one for a modern PoE switch that could support the PoE devices they have in their office. This was an extremely quick job only possible through organization: unplug all of the patch cables from the switch, swap them out, then plug the cables back in.

The other upgrade was installing a 10Gigabit network interface card (NIC) in the server, this increases bandwidth between the switch and the server; increasing bandiwdth between the server and the workstations upstairs. I was able to utilize the rail feature of the server so I could install the NIC while the server was still in the rack, this was a lot easier than picking it up and having to place it on its side. The upgrades would not have been easy without everything being installed in the server rack, showing just how important it is to stay organized.

Cable Management

The last part of the process was cable managing the workstations upstairs. This was another major pain point for the Mullen Family Dentistry office, as they were running into tech issues that were hard to diagnose with how tangled the old cables were.

For each workstation, I installed a USB hub with an extension under each monitor so that each workstation had easily accessible USB ports; ensuring organization wasn’t constrained by the length of each cable trying to make it to the desktop itself. This is a pattern I like to take with cable organization: power and internet below the desk, USB and other devices above the desk.

My favorite part about this project was using 3D printed components. The image on the right shows a 3D printed mount for the Ubiquiti access point, which was required as the office didn’t have the original mount. I also printed brackets that held velcro cable ties that screwed into the wall with drywall screws. This gave me extremely strong anchor points for each of the cable runs, an integral step to keeping everything clean.

Results

I had a lot of fun with this project as I got to apply things I’ve learned from personal projects on a production scale: ethernet cabling, server hardware organization, and cable organization. With my work completed, Mullen Family Dentistry now has adaptible infrastructure where problems are way easier to diagnose and fix. Any technician will be able to see what I’ve done and quickly make sense of MFD’s operation, cutting out the painful process of trying to figure out how everything was set up on their own. No more misleading labels, unused cables staying in nests, and untraceable problems. Thanks to Mullen Family Dentistry for letting me demonstrate my skills, and I hope to continue working on other systems and making IT better.
